How to Set Up a Tissue Paper Plant: A Project Planning Guide

How to Set Up a Tissue Paper Plant: A Project Planning Guide

Setting up a tissue paper plant starts with deciding what the factory will sell and which production stages it will operate. A business selling parent rolls to converters needs a different project scope from one buying those rolls and supplying packaged toilet tissue.

This guide provides a planning framework for defining production, utilities, responsibilities, and start-up targets before detailed engineering. Its checklists are suggested project tools; final requirements depend on the selected process and site.

1. Define Where Your Factory Starts and Ends

Choose the route before comparing proposals:

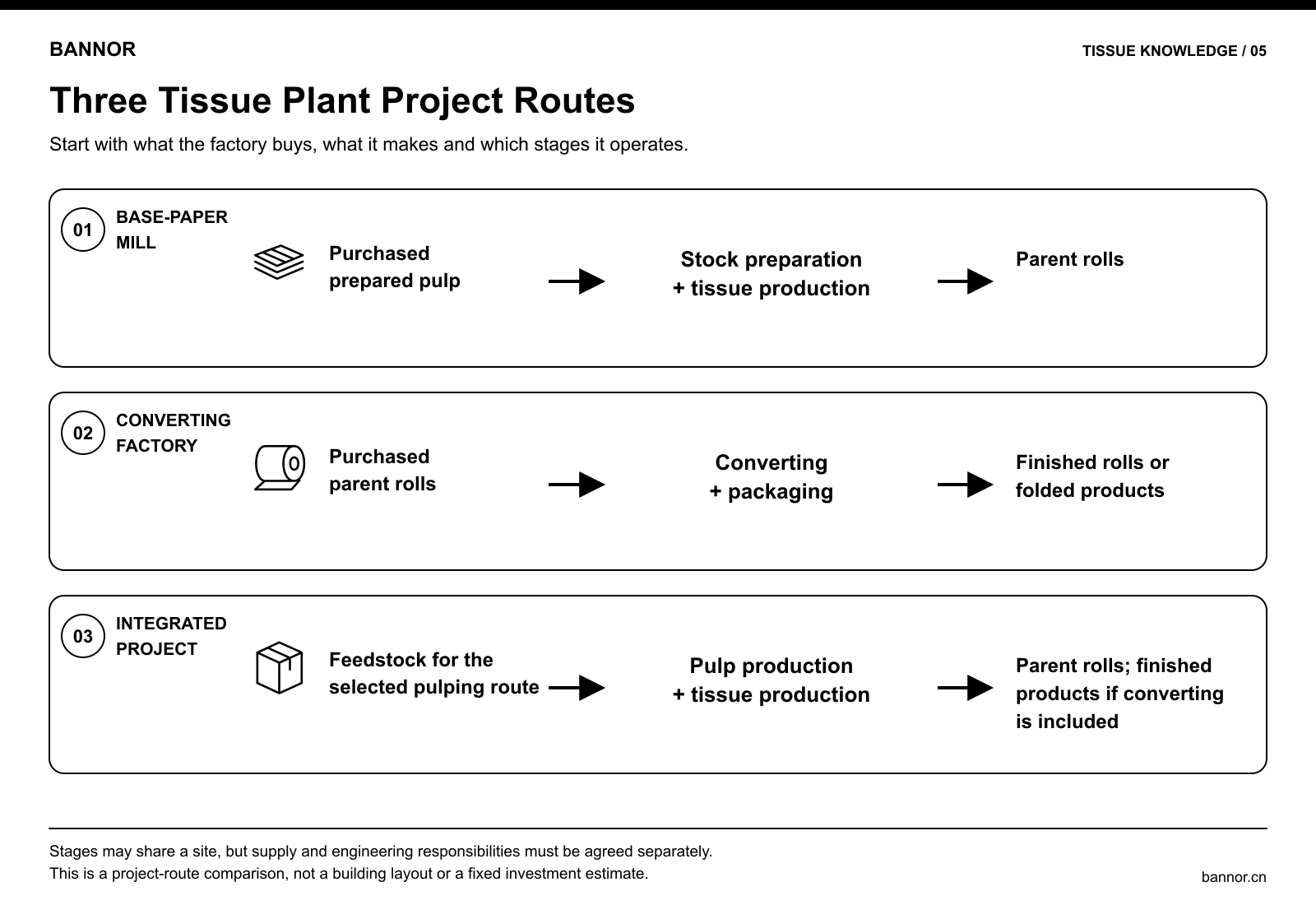

Project route Main input Main output Planning focus
Tissue base-paper mill Purchased pulp Parent rolls Stock preparation, papermaking, drying, utilities, and roll handling
Converting factory Purchased parent rolls Finished rolls or folded products Converting, packaging, storage, and dispatch
Integrated pulp and tissue project Feedstock for the selected pulping process Pulp and tissue, with converting if included Upstream pulp production as well as the tissue operation

These stages can share a site, but they remain separate engineering responsibilities. Valmet’s published Suzano project, for example, identifies tissue production, converting equipment, and energy equipment within a coordinated delivery. That distinction matters when deciding which parts of a new project are actually included. Valmet: Suzano tissue and converting project

If the project starts with purchased wood or bamboo pulp, receiving and preparing that pulp is different from producing pulp from wood or bamboo feedstock. Write the incoming material explicitly into the project brief.

2. Build the Product and Sales Plan First

A tissue paper business needs a defined customer and product mix. Start with conversations with potential buyers, then prepare a product sheet covering:

  • Sales channel: parent-roll customers, distributors, retail brands, or institutional buyers.
  • Product: toilet tissue or another separately specified tissue grade.
  • Quality targets: basis weight, strength, softness, appearance, and any agreed performance tests.
  • Delivery form: parent-roll dimensions or finished-product formats and packaging.
  • Demand: expected orders by grade, delivery frequency, and likely seasonal changes.

Use customer samples to describe the target. Avoid treating a sample as proof that any selected furnish and production route can reproduce it. Sample evaluation should lead to measurable requirements and, where needed, trials.

For a tissue paper manufacturing business plan, connect the sales forecast to the production schedule. A market estimate alone does not establish how much a new operation can sell each month.

3. Define Capacity as Saleable Output

State whether capacity means gross paper at the reel, accepted parent rolls, or packaged finished goods. Keep the time basis consistent: tonnes per operating day and tonnes per calendar year answer different questions.

A useful planning relationship is:

Annual saleable output = expected gross hourly output while running × scheduled operating hours × operating availability × saleable yield.

Use an hourly rate appropriate to the grade and expected running conditions, rather than design speed alone. The hourly rate here excludes downtime and rejects; if these are already included, applying the factors again would count the losses twice. Record the assumptions separately for each grade. Include scheduled maintenance, grade changes, start-up losses, and converting losses where applicable.

Do not derive an annual sales commitment from design speed alone. Match the base-paper schedule with converting and warehouse capacity, and distinguish the initial ramp-up period from established operation.

4. Confirm the Incoming Material Supply

For purchased pulp, gather supplier specifications, sample availability, delivery lead times, storage conditions, and expected consistency between shipments. If alternative pulp sources are planned, define how they will be evaluated before switching. For a detailed comparison, review raw materials for tissue paper.

A project using recovered paper requires preparation designed for that feedstock. Screening, cleaning, and any required deinking, reject handling, and water treatment must be considered together. ANDRITZ describes stock preparation, approach flow, recycled-fiber processing, and associated treatment systems as distinct parts of fiber preparation. ANDRITZ: Stock preparation

For a converting factory, the corresponding checks concern parent-roll quality, width, diameter, core dimensions, availability, and compatibility with the intended finished products. Specify a supply buffer based on actual replenishment conditions.

5. Check the Site and Utilities as One System

The production unit’s outline dimensions are only one input to building design. Reserve space for material receiving, storage, maintenance access, lifting, roll movement, auxiliary equipment, and future changes. Ask for a coordinated layout showing these areas before finalizing the building.

Prepare a utility schedule with the following information:

Utility or service Information to confirm
Electrical supply Connected loads, expected operating demand, supply characteristics, and metering boundary
Steam and condensate Required flow and pressure at the user connection, operating conditions, and condensate return arrangement
Hood heating Selected heat source and its connection requirements
Process water Available quantity, required quality, circulation, and treatment duties
Compressed air Required pressure, quality, and demand
Effluent and rejects Expected streams, collection points, and treatment scope

Thermal and electrical requirements interact. Valmet’s engineering discussion evaluates drying, steam balance, heat recovery, drives, and automation together. This supports checking the complete energy arrangement before selecting individual utility equipment. Valmet: Tissue mill energy systems

Record both peak supply requirements and expected consumption. Keep units clear: electrical power in kW differs from energy per tonne in kWh/t. Request operating conditions alongside every consumption estimate.

6. Assign Each Engineering and Delivery Responsibility

Use a responsibility matrix with separate columns for equipment supply, engineering, installation, supervision, testing, and owner-provided work. Include civil foundations, piping, wiring, controls, utility connections, lifting, and spare parts.

For each system connection, identify who provides the drawing, who installs the connection, and who checks it. A label such as “complete line” is insufficient without an agreed scope. Valmet’s tissue project guidance illustrates the multiple disciplines involved, from process and plant design to electrical work and start-up services. Valmet: Tissue project execution

Set document delivery dates early enough for building and utility work to use approved information. Record installation support and training as agreed deliverables with named responsibilities.

7. Organize the Budget Around the Whole Operation

Separate capital items into production equipment, preparation and treatment systems, utilities, buildings, installation, handling, quality control, and commissioning. Add initial consumables, spares, and working capital as clearly identified provisions.

For operating costs, model raw material, energy, water, process consumables, labor, maintenance, packaging, waste handling, and logistics as applicable. Test the effect of changes in pulp or parent-roll cost, selling price, utilization, and energy tariffs using local inputs.

Keep assumptions visible. A budget becomes useful when each amount has an identified basis, such as a supplier proposal, local tariff, staffing plan, or inventory requirement.

8. Agree on Start-Up and Acceptance Before Delivery

Prepare a staged checklist covering utility readiness, equipment checks, control verification, operator preparation, trial production, and acceptance testing. Control verification deserves its own milestone: ANDRITZ describes using tissue-mill simulation to examine process balances and test control logic before field operation. ANDRITZ: Tissue mill simulation

For production trials, agree on the furnish, grade, test duration, output boundary, sampling method, and treatment of downtime. Define the required quality measurements. Basis weight, thickness, tensile properties, formation, and softness are among the characteristics evaluated in ANDRITZ’s tissue laboratory. ANDRITZ: Tissue testing facilities

Record remaining defects, corrective responsibilities, operating documents, and spare-parts handover. Use the results to update the ramp-up plan.

Prepare a Brief for the Next Engineering Discussion

Bring the project route, target products, saleable capacity, proposed raw materials, site layout, available utilities, and scope matrix together in one brief. If the project includes producing parent rolls from pulp, review the tissue base-paper machine configuration and use that brief to identify the details requiring project-specific confirmation.

Previous articleToilet Paper Manufacturing Process: Key Controls for Tissue Base PaperNext article Raw Materials for Tissue Paper: Pulp Selection and Quality Trade-offs

Our Products

  • Bannor Laboratory Wet-Laid Nonwoven ProductionLine

  • Dryer Cylinder

  • PILOT PAPER MAKING LINE / Wetlaid Nonwoven making line

  • Crescent Former Tissue Paper Machine for Toilet Tissue

  • FLEXISOFT /CAL CALENDER

  • ELECTROMAGNETIC INDUCTION HEATING ROLLER

  • HEAT DISPERSING SYSTEM

  • AGITATOR AND PUMP SYSTEM

  • SCREENING SYSTEM

  • PIPE BELT CONVEYER

  • WASTEPAPER/PULP BALES/BROKEN PAPER CONVEYER LINE

  • BOARD STORAGE AND CONVEYING SYSTEM

  • Electrical Control System

  • FLAKE SCREEN

  • CHIP WASHING + WATER CIRCULATION SYSTEM

  • Chip Storage And Reclaiming System

  • Purchased Chip Line

  • CHIP SCREEN

  • FUNCTIONAL ROLLER SERIES

  • HIGH YIELD PULPING SYSTEM WITH AN ANNUAL OUTPUT OF 50000 TO 200000 TONS

View all products

Our Products

  • Bannor Laboratory Wet-Laid Nonwoven ProductionLine

  • Dryer Cylinder

  • PILOT PAPER MAKING LINE / Wetlaid Nonwoven making line

  • Crescent Former Tissue Paper Machine for Toilet Tissue

  • FLEXISOFT /CAL CALENDER

View all products

Why Bannor?

Custom made rolls being used for a wide range of applications.

Excellent raw material, up-to-date producing technology,

Highly trained employees, sophisticated machine technology

Contact Us

Zibo Bannor New Material Technology Co.,Ltd
86 533 2801410
86 533 2801460
sales03@bannor.cnhttps://bannor.cn/

About Bannor

Custom made rolls being used for a wide range of applications.

Excellent raw material, up-to-date producing technology.

Highly trained employees, sophisticated machine technology.

Our Products

  • Bannor Laboratory Wet-Laid Nonwoven ProductionLine

  • Dryer Cylinder

  • PILOT PAPER MAKING LINE / Wetlaid Nonwoven making line

  • Crescent Former Tissue Paper Machine for Toilet Tissue

  • FLEXISOFT /CAL CALENDER

  • ELECTROMAGNETIC INDUCTION HEATING ROLLER

  • HEAT DISPERSING SYSTEM

  • AGITATOR AND PUMP SYSTEM

  • SCREENING SYSTEM

  • PIPE BELT CONVEYER

View all products
